The difficulties of engineers and managers agreeing on how to invest in infrastructure maintenance stem from a basic inability to communicate with each other. This leads to the suboptimal management of infrastructure. Luckily, this situation can be remedied by engineers learning how to communicate their concerns in a way that managers can understand, so that they can clearly see whether a proposed action needs to be taken or can be deferred. This paper shows, with the help of a realistic example, in terms of infrastructure, methodology and techniques, how this can be done. The proposed approach, although upon reading is perhaps intuitive, is starkly absent in the literature in the field of infrastructure asset management. In the proposed approach, it is demonstrated how to improve the traditional approaches used by engineers to communicate to managers through (a) the quantification of the level of service as seen by mangers, (b) the modelling of how infrastructure might not provide the required level of service and (c) the way of showing how intervention programmes can affect the provision of service, both now and in the future.

Management of infrastructure often involves engineers and managers. Engineers, who are assumed in this paper to be those people responsible for deciding exactly what is to be done with pieces of infrastructure, are people with a technical background who are concerned about the details of how infrastructure functions, how it might fail and the processes that can cause this. Managers, who are assumed in this paper to be those people responsible for deciding how to allocate money for entire portfolios of infrastructure objects including across districts and regions, are people with a business background who are concerned with ensuring that infrastructure can meet the demands of it. Engineers and managers are working on the same team. Due to their different backgrounds, however, they sometimes have difficulty communicating with each other. This needs to be changed. The approach proposed in this paper, regardless of the infrastructure analysed or specific methodology or techniques used, bridges this gap. The proposed approach, although upon reading is perhaps intuitive, is one that has not yet been proposed in the field of infrastructure asset management.

In order to understand how this can be done, one needs to have a common understanding of infrastructure and infrastructure management. Infrastructure, at least in this paper, is considered to be the fixed physical objects that are needed to provide a service – for example, to allow people to travel between two cities within an hour. Infrastructure management is the process used to ensure that the infrastructure provides the service expected from it – for example, planning and executing interventions to prevent bridges from collapsing on the road between the two cities. The key for engineers and managers to understand each other is to focus on the service provided by the infrastructure. If it is accepted that infrastructure exists only to provide service, it becomes impossible to make reasonable decisions pertaining to infrastructure without explicitly considering it. Indeed, this is why there is room for improvement in many of the discussions between engineers and managers, as engineers do not frame their arguments, normally, in the language of why infrastructure is there. Instead, they focus on parts of the big picture, talking often about reliability, availability and safety. These parts are by all means important, but they are only proxies for what really matters – that is, service.

In order for engineers and managers to communicate and to understand the contents of this paper, it is not only the definitions of these words that need to be clear, but also how they relate to service. The definitions used in this paper are given in Table 1. These definitions were chosen by the authors to facilitate the writing of the paper. Of course, other definitions for these words are possible, but these ones nicely and clearly link them to the point of having infrastructure – that is, to provide service. Other definitions would not change the approach proposed in the paper or the ability to demonstrate its effectiveness. If other definitions or other proxies – for example, affordability – are used, they should also be tied to the service provided. Many discussions between engineers and managers end in frustration in the absence of clarity in these matters.

Table 1

Proxies

ProxyDefinition
AvailabilityThe amount of time that the travel time costs are below the maximum allowed travel time costs divided by the total time
ReliabilityThe probability that the costs will be lower than the maximum agreed on costs
SafetyThe probability of occurrence of accidents in which there are injuries or fatalities multiplied by the unit value of the injuries and fatalities
StateThe physical condition of the infrastructure

There has been in the past an extensive and growing amount of literature on decision making with respect to infrastructure. This can be grouped as literature focused on (a) technical aspects, such as reliability, availability and safety; (b) multicriteria decision analysis, which is focused on weighting more than one criteria in often subjective ways; and (c) cost–benefit analysis. The literature in all three categories contains text stemming from research and from practice in the form of guidelines or supporting software. Some of the most representative literature in each category is presented and discussed in the next three sections.

There is in literature an abundance of examples where justification for infrastructure decisions are given based primarily on technical aspects, which are essential used as proxies for providing service. In every case, the quantification of how service might be affected would enable better decisions to be made. A few of the examples found in literature are given in Table 2, which includes, per example, the technical criteria used, the decision made and an example improvement. Table 2 is to be read as follows: it is reported in Calle-Cordon et al. (2017) that the technical criteria reliability, availability, maintainability and safety can be used to determine the interventions to be executed on switches and crossings. An improvement in the determination of the interventions to be executed can be obtained by additionally quantifying the costs of lost service in any situations when they might occur. For each reference, only one example is given. By following the proposed approach, such improvements would be ensured.

Table 2

Examples of technical aspects used as proxies in infrastructure decision making

ReferenceTechnical criteriaDecision madeAn improvement would be to quantify additionally …
Calle-Cordon et al. (2017) Reliability, availability, maintainability and safetyInterventions to be executed on switches and crossingsCosts to users of lost service
Patra (2009) Reliability, availability, maintainability and safetyInterventions to be executed on railway infrastructureCosts to users of lost service
Zio et al. (2007) Reliability of objects, delays due to speed restrictions caused by deteriorated conditions and interventionsInterventions to be executed on tracksRisks related to delays
Jaedicke et al. (2013) Probability of being hit by a landslideRank of objects for interventionCosts of being hit
Liu et al. (2014) Probability of collision between cars and trains at level crossingsRank of level crossings for interventionCosts of travel delays in case of collisions at level crossings
Jafarian and Rezvani (2012) Probability of derailment, the condition of objectsRank of objects for interventionCosts of possible accidents and traffic interruptions
Peterson and Church (2008) Consequences on network operation in terms of traffic flowRank of bridges and tunnels for interventionCosts of losing network operation
Kurauchi et al. (2009) Consequences on network operation in terms of traffic flowRank of links for interventionRisks related to network operation
Fecarotti et al. (2015) Probability and duration of loss of network operationRank of railway tracks, switches and stations for interventionRisks related to network operation
Chang and Nojima (2001) Consequences on network operation in terms of traffic flowEstimate infrastructure disruption and restoration costs after earthquakesRisks related to network operation after earthquakes
Sun and Gu (2011) Roughness, deflection, surface deterioration, rutting, skid resistanceRoad interventions to executeCosts of reductions in service due to increased roughness

There is in literature an abundance of examples where justifications for infrastructure decisions are given based on the results of multicriteria decision analysis. Some of these works assign values to multiple technical aspects, some combine technical aspects and estimations of level of service and some combine estimations of the level of service without reverting to direct valuation of the levels of service – that is, costs. In every case, a direct valuation of how the infrastructure might not provide service would enable better decisions to be made. A few examples of each of these are given in Tables 3 and 4, which include a summary of the criteria used, the decision made and an example improvement. Tables 3 and 4 are to be read as follows: it is reported by Carretero et al. (2003) that the probability of failure multiplied by the costs of restoring the infrastructure can be used to determine which interventions to be executed on tracks. An improvement can be obtained by additionally quantifying the costs of injuries, fatalities, damaged equipment and downtime due to failures when they might occur. For each reference, only one example is given. By following the proposed approach, such improvements would be ensured.

Table 3

Examples of multicriteria decision analysis in infrastructure decision making (1/2)

ReferenceTechnical criteriaDecision madeAn improvement would be to quantify additionally …
Carretero et al. (2003) Probability of failure multiplied by the costs of restoring the infrastructureThe interventions to be executed on tracksThe costs of injuries, fatalities, damaged equipment and downtime due to failures
Stein et al. (1999) The probability of scour at bridge foundations, cost of maintenance, cost of passenger delayThe rank of bridges for interventionThe costs of injuries and fatalities due to bridge failures
Cheng and Tsao (2010) Reliability, travel time, passenger safety, quality of service, intervention costsThe interventions to be executed on rolling stocksThe costs of injuries and fatalities due to bridge failures
Celebi et al. (2008) Quality of service, travel time, spare part costs, storage costsThe interventions to be executed on tracksThe costs of lost quality of service
Ebrahimnejad et al. (2012) Staff required, project duration, fit with company fit, with objectives and policy, fit with budget, risk/return ratio, fit with regulations, fit with standards, fit with terms of contract, ability of management to execute, ability to avoid conflicts, contribution to environmental protection, contribution to health and safety, knowledge regarding the technology to be usedThe track to be installedThe costs of injuries and fatalities due to heavy rain
Table 4

Examples of multicriteria decision analysis in infrastructure decision making (2/2)

ReferenceTechnical criteriaDecision madeAn improvement would be to quantify additionally …
Caterino et al. (2006) Service interruption during interventions, cost of construction; cost of interventionsThe seismic retrofitting interventions to be executed on a reinforced-concrete structureThe costs of service interruption
Dawotola et al. (2009) Externalities, corrosion, operational errors, structural defects, cost of interventionsThe design, construction, inspection and maintenance strategy for petroleum pipelinesThe costs of lost service due to deterioration
Frangopol and Liu (2007), Liu and Frangopol (2004) Costs of intervention, safety, condition, environmental impactThe bridge intervention strategyFailure costs
Guhnemann et al. (2012) Costs of intervention, safety, environmental impactThe road intervention strategyFailure costs
Guhnemann et al. (2012) Importance of the project and the sector, cost of intervention and suitability of finance, execution and operation, probability of failure and consequences of failure of the infrastructureThe urban infrastructure projects to financeThe costs of delays and accidents

There is in literature an abundance of examples where justification for infrastructure decisions are given based on the results of cost–benefit analysis. These works often attempt to quantify all effects on service by assigning to them either costs or utility. They often, however, do not cover all important aspects of service. A few examples of each of these are given in Table 5, which includes a summary of the costs and benefits used, the decision made and an example of service not covered. Table 5 can be read as follows: it is reported by Peng (2011) that the decision of how to group interventions on tracks can be made by taking into consideration the costs of intervention and the costs of network operation. An improvement, however, would be to take additionally into consideration accident costs. For each reference, only one example is given. By following the proposed approach, such improvements would be ensured.

Table 5

Examples of cost–benefit analysis in infrastructure decision making

ReferenceCosts and benefitsDecision madeA further improvement would be to quantify …
Peng (2011), Peng and Ouyang (2014) Costs of intervention, costs of network operationHow to group interventions on tracksAccident costs
Zhao et al. (2006) Costs of interventionBallast tamping intervention strategyAccident and travel time costs
Budai-Balke (2009) Costs of interventionTrack intervention strategyAccident cost
Thoft-Christensen (2009) Costs of interventionBridge intervention strategyAccident cost
Zhang et al. (2013) Costs of intervention, safety, travel disruptionTrack intervention strategyTravel time costs
Lyngby et al. (2008) Cost of intervention, cost of failure (i.e. cost of unavailability of service due to failure)Interventions to be executed on tracksRisks related to accidents, costs for traffic interruption due to preventive interventions

The literature review shows that many people are concerned with making the right decisions with respect to maintaining infrastructure. It also clear, though, that everyone is looking at only part of the problem, either by not explicitly relating things to the service provided or by not capturing all of the relevant service provided. This means that when they present their ideas to a manager, the manager, presented with an incomplete picture, loses confidence in what it presented and knows it does not fully represent what they care about. This forces or enables them to revert comfortably to his own preformed opinions. This leaves frustrated engineers, on the less serious side of things, but also to managers making suboptimal decisions with respect to their infrastructure, on the more serious side of things. The latter can lead to unnecessary wasting of money now or in the future, unnecessary increases in user disturbances now or in the future or, even worse, unnecessary increases in the number of accidents that may happen.

In order for engineers to be able to communicate their concerns – for example, with respect to risk, reliability, availability and safety – to managers in a way that they can understand, engineers need to realise what is important to managers. Managers are not interested in the technical aspects. They operate at the system level and are concerned with how their infrastructure is going to function as a whole and how the infrastructure is going to provide service. They are interested only in taking action to fix a technical issue if they feel that how their infrastructure functions as a whole is in jeopardy and the costs of doing so are justified. This means that the engineers have to be able to show that the state of the infrastructure leads to negative impacts on, or costs to, the stakeholders. As managers are concerned with not only right now, but also the future, engineers must be aware that they have to be sure to convey to managers that they know, and have modelled well, not only how the entire system functions now but also how it functions in the future. As one cannot, of course, model everything, the engineer, when communicating with managers, needs to be sure that they cover all aspects that are of concern to the managers and models the differences of what will happen when the engineer’s advice is followed and when not. Additionally, engineers must ensure that when it comes to displaying the results of their simulations that they focus on the things that matter to managers at the right level and not on the things that are important to the engineer. Of course, the models that are used for communication do not replace the ones required by the engineers to propose very specific answers to specific problems, but are rather built on top of, or in conjunction to, these models. The four basic steps to ensure that engineers can speak to managers are described in the next four subsections, using a fictive but realistic railway network (Figure 1), where it is hoped to determine how much money is to be spent on maintenance. The network consists of 86 bridges with a total deck surface area of 20 076 m2, 73 track sections measuring a total of 211 242 m length, 66 earthworks measuring a total of 360 261 m3 and 130 switches. The numbers of trains per day on each of the 11 links are given in Table 6, and each carry on average 100 passengers.

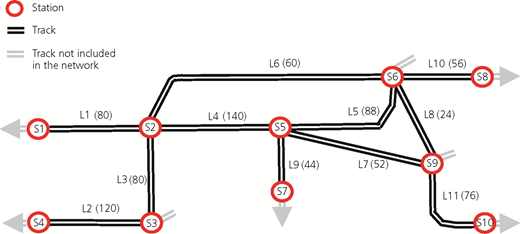

Figure 1

Network layout (transit per day are reported in parentheses on each line)

Figure 1

Network layout (transit per day are reported in parentheses on each line)

Close modal
Table 6

Links in the network with the daily train traffic per link

LinkFrom–toTrains per dayLinkFrom–toTrains per dayLinkFrom–toTrains per day
L1S1–S280L5S5–S688L9S5–S744
L2S4–S3120L6S2–S660L10S6–S856
L3S3–S280L7S5–S952L11S9–S1076
L4S2–S5140L8S6–S924N/AN/AN/A

In order to conduct the example, a relatively common methodology and relatively common techniques are used. As the goal of the paper is to explain an approach that can be used by engineers to communicate in terms of service to the manager, the details of the used methodology and tools are intentionally omitted. This omission helps to keep focus on the goal of the paper and avoids giving the impression that the authors are suggesting the use of a specific methodology or specific techniques.

The first step is to provide a complete description of the infrastructure to be included in the analysis – complete, but not necessarily deep, or only as deep as necessary. For example, an infrastructure manager needs to know that all objects that are required to provide the required service are included in the evaluation – for example, all earthworks, all tracks, all bridges and all switches – but it is not necessary for them to know that each beam in steel bridge number 10 is modelled exactly. It is also not of much use to them if someone is conducting an evaluation with just bridges, even if modelled in lots of detail. The most they will get out of such an analysis is a prioritisation of which bridges should have an intervention in the next planning period and how much they would cost. They will, however, most likely be left with no idea of how to compare the need for expenditure on the most important bridge with the interventions required on the track sections, the earthworks or switches. The usefulness of the evaluation for the manager decreases significantly without covering all of the objects and all of the objects in the same way. All of the objects in the example network in this paper, and their four possible states, which cover all possible states in which they can be, are shown in Tables 7 and 8 per link, classified by object type. The object types consist of three bridge types (metal, concrete and masonry), one track type (track), two earthwork types (embankment and cutting) and one switch type (turnout). The tables are to be read as follows: of all of the metal bridges, there are none to be found on link 1 in any state, one in state 1 which measures 32 m2 and one in state 2 which measures 19 m2 on link 2, two in state 2 which together measure 127 m2 on link 3, one in state 1 which measures 104 m2 on link 4, five in state 1 which measure 311 m2, four in state 2 which measure 561 m2, five in state 3 which measure 443 and one in state 4 which measures 70 m2 on link 5 and one in state 1 which measures 124 m2 on link 6. The bridges are measured in square metres of deck surface area.

Table 7

Number and extent of objects in each state for links 1–6

Object typeUnitStateL1L2L3L4L5L6
NumberExtentNumberExtentNumberExtentNumberExtentNumberExtentNumberExtent
BridgeMetalm210013200110453111124
200119212700456100
300000000544300
40000000017000
Concretem21000000000000
20000000011700
3000000000000
4000000000000
Masonrym2100000000499100
2001600000429871211
300000000236300
4000000000000
Trackm10054716713 54100136000
20044748676 8763636300215 249
3231 495262244051520358300
4000000140681429100
EarthworkEmbankmentm3119051210700000000
2000000000000
3002773600000000
4000000000000
Cuttingm31000013488428 695212 01612831
2000012598367022260641952
3000013292728815765315 051
416160014981000013105
SwitchTurnoutNumber10 5 9 5 3 1
20 3 10 4 3 3
30 6 12 0 2 1
40 1 2 0 0 0
Table 8

Number and extent of objects in each state for links 7–11

Object typeUnitStateL7L8L9L10L11Total
NumberExtentNumberExtentNumberExtentNumberExtentNumberExtentNumberExtent
BridgeMetalm2100120847850000131564
2249500617710000152973
30011041154337300101074
4000000130002100
Concretem21003774000022085982
2003357000011045478
3000000000000
4000000000000
Masonrym21004126621147212512603145258
20021191208110422167124794
300256612082938262992704
40000000011491149
Trackm121744447165219 464102338 768
2214477125332544266019 33029127 877
316931217000015211735 431
400280700000049166
EarthworkEmbankmentm310012414368990000612 325
200522 2462978411 072001134 297
300213 126215 7832475400841 399
4000000000000
Cuttingm31256 4980000112 911362 59014179 028
2218 319112 6160000001344 793
300000000373791035 812
40000000013906412 607
SwitchTurnoutNumber13 8 0 2 4 40
27 12 2 1 1 46
34 10 1 1 2 39
40 2 0 0 0 5

The level at which the object types are defined is selected to provide a balance between understanding of the objects in the network and providing an overview of all of the objects in the network. Not all engineers would be happy with this classification. Engineers have a tendency to want more details than necessary and are often too willing to sacrifice the overview, or, in other words, engineers are often not willing to work at a high-level abstraction. As managers have to work at a high level of abstraction, as there is only so much time to obtain an overview, engineers have to as well if they want to provide an overview in a way that a manager will understand. For example, if one treated the objects in the network individually, instead of grouping them together and looking at them as seven types of objects (Tables 7 and 8), a manager would need to look at all 355 individual objects, which is a drastic increase in analysis effort and the manager risks getting lost in the details. The right level of abstraction depends on the time of both the engineer and the manager.

The next thing that needs to be determined is who and what is important. Engineers often make the mistake of thinking that managers are interested in the technical details. Perhaps they are, but they do not give it first priority. Primarily, managers care about the service that they are providing and how non-functioning infrastructure may affect this service. In order to identify this, one needs to know the stakeholders and how they will be affected if the infrastructure does not work as intended. The clearest way to do this is to express how each stakeholder is affected per unit that can be measured over time and to which people can attribute monetary values. In the example presented in this paper, it is assumed that there are only two stakeholders who can be affected in three different ways: the owner, who is affected by having to pay for interventions and the users who are affected by losing travel time and being involved in accidents. Although many more stakeholders are possible, as are many more ways of how they are affected, these are sufficient to make the point – that is, that engineers have to take into consideration everything that is important to the manager. For example, in the situation presented in the example, if an engineer is telling a manager that an intervention on a bridge is required to save lives, the manager is wondering if the engineer is giving adequate consideration to the intervention costs and the additional travel time costs that will be incurred from executing the intervention, in addition to loss of life, that will occur if a failure leads to an accident. Unless the engineer has in mind all of the same stakeholders and how they are affected as the manager, their argument will not carry much weight.

To facilitate the explanation of how stakeholders are affected, impacts should be broken down into units that can be measured over time and to which monetary values can be associated. Breaking down the impacts per unit time is necessary to ensure that there is a clean separation between (a) the modelling of the infrastructure and the system in which it is embedded and (b) enabling decision makers to assign values to things that are directly comparable in ways that can be easily argued over and discussed, without additional modelling. One can, for example, easily assign a monetary value to 1 h of additional travel time and reasonably discuss how this value compares to the cost of fixing a track section. One cannot, however, easily assign a monetary unit to an increase in system reliability and reasonably discuss how this value compares to the costs of fixing a track section. This is because reliability is a system characteristic that gives a manager an idea of which possible future scenarios are likely – that is, failure or no failure – but does not say how stakeholders are affected. It is without doubt an interesting value, but not one that is directly useable in making decisions of where interventions on a network are to be executed.

The ways that the stakeholders are considered to be affected in the example are shown in Table 9 – that is, these are things on which a value will be put on. It is to be read as follows: the owner is a stakeholder to whom intervention costs are attributed – that is, the owner has to pay for interventions. The amount that the owner pays for the intervention is the cost of the material, machinery and labour required to execute interventions – that is, the economic impact. This cost is estimated by amount they pay for manual labour, machinery and materials listed on the final bills of executed interventions. These costs are estimated by multiplying the number and extent of interventions to be executed and the unit costs of the intervention, which vary as a function of the intervention executed. Monetary values are used instead of others – for example, utility – because they are the intuitive unit used to put values on things. By leaving out a cost to the user of not making a trip, it is being assumed that the number of people who no longer make trips multiplied by the value of these lost trips is negligible. Even if trains do not run, it is assumed that replacement buses will be used. Only passenger travel time is considered. It is assumed that all property damage costs are attributed to the user, including the train operators. This does not mean that the owner will not pay for them in the end – for example, through insurance. A complete list for railways, including the ability to transport freight, can be found in the publication by Papathanasiou et al. (2016) and that for roads can be found in the paper of Adey et al. (2012), and how they change over time in the publications of Adey et al. (2012) and Adey (2017). For clarity, it is pointed out that it is important to define the stakeholders and how they are affected per system being analysed, taking into consideration the decision to be made and the stakeholders involved. The example given in this paper is only for illustrative purposes. An example of something not included is the value that the general population, as stakeholders, would put on negatively affecting the environment – for example, emitting more than the expected carbon dioxide (CO2). A more detailed discussion of such issues can be found in the publication by Adey et al. (2012).

Table 9

Stakeholders and how they are affected

StakeholderCosts
LabelDescriptionEstimated by …IndicatorUnitUnit cost: €/unit
OwnerInterventionsThe economic impact of material, machinery and labour to execute interventionsThe cost of manual labour, machinery and materials listed on the final bills of executed interventions – that is, cost of interventionThe type and extent of interventions executedExtent of interventionsTables 18 and 19
UsersTravel timeThe economic impact of a passenger losing timeThe additional travel time required when an intervention is being executed and no intervention being executed multiplied by the unit costThe additional travel time required when trains cannot travel at the reference speedMinutes of additional travel time0·5
AccidentsThe economic impact of having property damaged in an accidentThe cost of repairing the damaged propertyThe extent of damaged propertyNumber of accidents100 000
The societal impact of being injured in an accidentThe number of injuries multiplied by the average amount that society is willing to pay to avoid being injuredThe number of injuriesNumber of people50 000
The societal impact of being killed in an accidentThe number of fatalities multiplied by the average amount that society is willing to pay to avoid being killedThe number of fatalitiesNumber of people1 000 000

Once it is established how the impacts are connected with the object states, for those that can be directly connected to object states, how the system is to be modelled needs to be explained clearly. This includes (a) how objects change over time, (b) how the level of service required from the objects changes over time, (c) how future scenarios for the infrastructure are determined and (d) how stakeholder costs are estimated. These points are explained in succession in the following sections.

How objects change over time

The state of an object deteriorates and is improved through the execution of interventions over time. It needs to be clear how the changes of state over time are modelled. In the example presented in this paper, this is done with transition probabilities – that is, each object has a probability of transitioning from one state to another in 1-year periods, which depend on whether the object is deteriorating (Table 10) or being improved through the execution of an intervention (Tables 11 and 12). Each object is modelled independently – that is, the possibility of correlated failures is neglected. Even though it is clear that this is an approximation (Adey et al., 2004), this assumption greatly simplifies the overview for infrastructure managers. More information on how the values shown in Table 17 are combined to show the evolution of state over time can be found in Adey and Hajdin (2011).

Table 10

Probabilities of moving from one state to another in time intervals when no preventive interventions are executed

Object typeState at tState at t + 1Object typeState at tState at t + 1
12341234
BridgeMetal1a0·950·050·000·00EarthworkEmbankment10·850·150·000·00
20·000·980·020·0020·000·970·030·00
30·000·000·970·0330·000·000·960·04
40·000·000·001·0040·000·000·001·00
Concrete10·990·010·000·00Cutting10·870·130·000·00
20·000·970·030·0020·000·980·020·00
30·000·000·900·1030·000·000·970·03
40·000·000·001·0040·000·000·001·00
Masonry10·940·060·000·00SwitchTurnout10·500·500·000·00
20·000·910·090·0020·000·840·160·00
30·000·000·950·0530·000·000·700·30
40·000·000·001·0040·000·000·001·00
Tracks10·700·300·000·00
20·000·900·100·00
30·000·000·840·16
40·000·000·001·00
a

The table is to be read as follows: if a metal bridge is in state 1 at time t, then it has a 0·95 probability of being in state 1 at t + 1, 0·05 probability of being in state 2 at t + 1 and 0 probability of being in state 3 or 4 at t + 1

Table 11

Information for estimating intervention and travel time costs due to preventive interventions

Object typeIntervention typeState in which the intervention can be executedProbabilities of an object being in each state following interventionUnitIntervention costs: €/unitDuration of traffic disruption: d/unit
1234
BridgeaMetalRehabilitation30·800·200·000·00m230000·080
RenewalAll1·000·000·000·0050000·100
ConcreteRehabilitation30·600·400·000·00m210000·060
RenewalAll1·000·000·000·0075000·120
MasonryRehabilitation30·500·500·000·00m210000·080
RenewalAll1·000·000·000·0080000·150
TrackRehabilitation30·600·400·000·00m7·50·0001
RenewalAll1·000·000·000·007500·0004
EarthworkEmbankmentRehabilitation30·800·200·000·00m34000·008
RenewalAll1·000·000·000·0030000·008
CuttingRehabilitation30·800·200·000·00m34000·008
RenewalAll1·000·000·000·0030000·02
SwitchTurnoutRehabilitation30·900·100·000·00Number10 0000·13
RenewalAll1·000·000·000·00400 0002·00
a

The table is to be read as follows: when a rehabilitation intervention is executed on a metal bridge that is in state 3, at t+ there is a 0·8 probability that it will be in state 1 following the intervention, a 0·2 probability that it will be in state 2 following the intervention and 0 probability that it will be in state 3 or 4 following the intervention. This intervention will cost the extent of the bridge measured in square metres multiplied by €3000/m2, and the traffic will be disrupted by the extent of the bridge measured in square metres multiplied by 0·08 d/m2

Table 12

Information for estimating intervention and travel time costs due to corrective interventions

Object typeUnitIntervention costs: €/unitDuration of traffic disruption: d/unit
BridgeaMetalm240000·097
Concretem230000·073
Masonrym220000·098
Track m2000·0002
EarthworkEmbankmentm320000·02
Cuttingm320000·02
SwitchTurnoutNumber45 0000·45
a

The table is to be read as follows: when a corrective intervention is executed on a metal bridge, it will cost the extent of the bridge measured in square metres multiplied by €4000/m2, and the traffic will be disrupted by the extent of the bridge measured in square metres multiplied by 0·097 d/m2

How the required levels of services are expected to change over time

The levels of services required from objects and how they change over time need to be considered. Many interventions proposed by engineers fail when they reach the manager’s desk because they have not taken into consideration the future changes in these levels of services. For example, a manager will not agree to execute a maintenance intervention on a bridge when the railway link in which it is embedded is to be taken out of service in 10 years or if there is a high chance that it will need to be replaced with one that can run high-speed trains within 10 years. In the example in this paper though, it is assumed that levels of service are constant. More information on investigating changes in levels of services can be found in the publications by Martani et al. (2016, 2018), Esders et al. (2015, 2016), De Neufville and Scholtes (2011), De Neufville et al. (2006, 2008) and Ellingham and Fawcett (2007).

How future scenarios for the infrastructure are determined

The state of the infrastructure and the evolution of the state of the infrastructure over time provide a manager with an idea of how much they will be required to spend now and in the future to ensure that the infrastructure provides the levels of services required of it. In the example, this is estimated over a 40-year time period using the initial states of the objects and the transition probabilities (Tables 10–13). Table 11 is to be read as follows: in one time interval, one of three types of interventions can be executed on a metal bridge – that is, a do-nothing intervention, which is not shown; a rehabilitation intervention; or a renewal intervention. If a rehabilitation intervention is executed when the bridge is in state 3, there is a probability of 0·8 that the bridge will be in state 1 at the beginning of the next time period and a probability of 0·2 that it will be in state 2. The rehabilitation intervention will cost the owner €3000/m2 multiplied by the extent of the bridge, and traffic will be disrupted by 0·08 d/m2. For example, a rehabilitation intervention on a 100 m2 metal bridge would, therefore, cost on average €30 000 and traffic would be disrupted for 8 d. Table 12 is to be read as follows: if a failure of a metal bridge occurs, a corrective intervention will be executed. The corrective intervention will cost €4000/m2 multiplied by the extent of the bridge. Traffic will be disrupted for 0·097 d/m2 multiplied by the extent of the bridge. For example, a corrective intervention on a 100 m2 metal bridge would, therefore, cost on average €400 000 and cause a traffic disruption of 9·7 d. It is assumed that on average a corrective intervention restores the state of the object to the state before failure. The costs are greater and the duration of traffic disruption is longer for an average corrective intervention than those for preventive interventions. Table 13 is to be read as follows: for a metal bridge, the probability of failure within 1 year if it is in state 1, 2, 3 and 4 is 8 × 10−6, 3 × 10−4, 5 × 10−3 and 0·05, respectively. If the bridge is in state 2 and a failure occurs, there is a probability of 0·3 that this failure will lead to an accident. If there is an accident, 80% of the people in the train will be injured and 20% of the people will lose their lives. The probabilities of failure are estimated per object. It is assumed that two objects, regardless of their extent, have the same probability of failure if they are in the same state.

Table 13

Information for estimating accident costs due to failures

Object typeUnitStateProbability of failure per unitProbability of accident per failureProbability of injury per accident per person in trainProbability of fatality per accident per person in train
BridgeaMetalNumber18 × 10−60·30·80·2
23 × 10−4
35 × 10−3
40·05
ConcreteNumber12 × 10−60·20·80·2
22 × 10−4
35 × 10−4
43 × 10−3
MasonryNumber14 × 10−80·250·80·2
23 × 10−6
33 × 10−4
46 × 10−4
TrackNumber10·00250·10·40·05
20·025
30·075
40·25
EarthworkEmbankmentNumber17 × 10−50·50·40·05
28 × 10−4
37 × 10−3
45 × 10−2
CuttingNumber17 × 10−60·30·20·005
27 × 10−5
34 × 10−3
49 × 10−3
SwitchesTurnoutNumber10·010·10·50·05
20·10
30·25
40·50
a

The table is to be read as follows: when a metal bridge is in state 1, it has a probability of failure of 8 × 10−6. If it fails, there is a probability of 0·3 that there will be a train that will have an accident due to this failure. If there is an accident, there is a 0·8 probability that a person on the train will be injured and a 0·2 probability that a person will lose their life

If an engineer is going to make recommendations of what should be done to infrastructure, both now and in the future, they will need to explain clearly how it is determined when and which interventions are to be executed. To be more exact, the engineer needs to show over the time period in which the manager cares about how the infrastructure will change. This is the most clearly stated when the intervention strategies are clear – that is, if the set of x conditions arise then y interventions will be executed. For example, in the example used in this paper, the engineer is considering executing interventions conditional on the state of the objects at each point in time (Table 14). Table 14 can be read as follows – referring to strategy 2, if a bridge is in state 1 at time t, then nothing will be done; if a bridge is in state 2 at time t, nothing will be done; if a bridge is in state 3 at time t, a strengthening intervention will be executed; and if a bridge is in state 4, a renewal intervention will be executed. All strategies labelled strategy 1 are referred to as strategy set 1. All strategies labelled strategy 2 are referred to as strategy set 2. By modelling the deterioration and the improvement following the possible intervention strategies, the future can be simulated. Having all reasonable intervention strategies considered, from the engineer’s and the manager’s points of view, is important. If one intervention strategy that the manager sees as possible is missing, it already gives them the impression that not everything is covered and, therefore, there is a hole in the engineer’s argument.

Table 14

Candidate intervention strategies per object type

Object typeStrategyState
1234
Bridge1NoneNoneNoneRenewal
2NoneNoneRehabilitationRenewal
Track1NoneNoneNoneRenewal
2NoneNoneRehabilitationRenewal
Earthwork1NoneNoneNoneRenewal
2NoneNoneRehabilitationRenewal
Switch1NoneNoneNoneRenewal
2NoneNoneRehabilitationRenewal

How impacts on stakeholders are estimated

COSTS AND RISKS

Once the manager is content with how the system is modelled, they needs to know how the impacts on the stakeholders are estimated. In the example presented in this paper, this means the owner costs due to the execution of interventions, the user costs due to additional travel time and the user costs due to accidents, where each is estimated per object per unit of time. How these costs are estimated are shown in the following sections, where it is assumed that the costs related to each object per unit time can be estimated as a function of the state of the object at the beginning of each unit time. The equations used to estimate the costs and risks in each unit of time are given in Equations 1 and 2, respectively. Explanations of the variables are given in Tables 15 and 16. It is noted that the equations for the estimation of risks in years with and without interventions are the same. The variations occur only in the estimation of the values of the probabilities of occurrence of failure. The probability of accidents occurring on construction sites is considered negligible.

1
2
Table 15

Explanations of variables in Equations 1 and 2 (1/2)

VariableExplanationEquation/comment
Cpi-iPreventive intervention costsoOsS(epi-os×ucpi-os)
Cpi-ttTravel time costs due to preventive interventionsoOiI(tpi-o×v×p×att×uctt)
Cpi-aAccident costs due to preventive interventions0
Rf-iCorrective intervention risks (i.e. probability of failure multiplied by the costs of corrective interventions)oOsS(pf-os×eci-o×ucci-o)
Rf-ttTravel time risks (i.e. probability of failure multiplied the additional travel time costs)oOsS(pf-os×tf-o×v×p×att×uctt)
Rf-aAccident risks (i.e. probability of failure multiplied by the conditional probability of accident given a failure and the number of people on the train multiplied by the accident risks conditional on a failure)oOsSpf-os×pa-f×p×(pa-pd×uca-pd+pa-inj×uca-inj+pa-fat×uca-fat)
attAdditional travel time per train20 min/d – assumed to be constant for all interventions
eci-oExtent of object o in state s to have a corrective interventionCalculated using transition probabilities in Tables 10 and 11 and the strategies in Table 14
epi-osExtent of object o in state s to have a preventive interventionCalculated using transition probabilities in Table 10 and the strategies in Table 8
Table 16

Explanations of variables in Equations 1 and 2 (2/2)

VariableExplanationEquation/comment
pNumber of passengers per train100
pa-fConditional probability of accident given a failure has occurredIn Tables 12 and 13
pa-pdProbability of occurring property damageIn Tables 12 and 13
pa-fatProbability of being killedIn Tables 12 and 13
pa-injProbability of being injuredIn Tables 12 and 13
pf-osProbability of failure of object o in state sIn Tables 12 and 13
ppi-osTime required to execute a preventive intervention on object o in state sIn Tables 12 and 13
tf-oTime required to execute the corrective interventionIn Tables 12 and 13
ucttUnit cost of travel timeTable 7
uca-fatUnit costs being killedTable 7
uca-injUnit cost of being injuredTable 7
uca-pdUnit cost of property damageTable 7
ucci-oUnit costs of a corrective intervention on a unit of object oIn Table 10
ucpi-osUnit costs of a preventive intervention on object o in state sIn Table 11
vNumber of trains running per unit timeDepending on the line, Table 6
PROXIES

Although the clearest way to evaluate how stakeholders are affected is through costs per unit time, many engineers and managers are interested in proxies of things that are important to managers. This is particularly clear when one looks through the literature on infrastructure decision making as pointed out in the section headed ‘Literature review’. These are only useful, though, if it is clear how they are related to how stakeholders are affected. Commonly used proxies include those defined in Table 1. How each of these is estimated in this paper are explained in Table 17. Simultaneous failures and simultaneous execution of interventions are intentionally neglected even though they can have a large effect on results (Adey et al., 2004). Likewise, it is assumed that an object can have a maximum of only one failure per year and one intervention per year. These assumptions are made in order to keep the focus on the main message of the paper.

Table 17

Proxies

ProxyDefinitionShown as
StateThe physical condition of the infrastructureAverage state of all objects weighted by extent per year and as percentage of extent of all objects in each state per year
ReliabilityThe probability that the costs will be lower than the maximum agreed on costsAverage reliability of all objects weighted by extent per year and cumulative distribution of reliability of extent of all objects per year
AvailabilityThe amount of time that the travel time costs are below the maximum allowed travel time costs divided by the total timeAverage availability of all objects weighted by extent per year and cumulative distribution of availability of extent of all objects per year
SafetyThe probability of occurrence of accidents in which there are injuries or fatalities multiplied by the unit value of the injuries and fatalitiesAverage of the probabilities of accidents with at least one injury or fatality due to all objects per year

In order to have managers understand why specific intervention strategies should be followed, they need to be able to see what effect their decision makes on the stakeholders. They need to be able to do this for the whole time period being investigated (Figures 2–4) and at smaller intervals within that time period (Figure 5). Once this is clear, it is useful to show the values of the proxies for the whole time period and at smaller intervals within that time period. The costs and proxies are shown in the following two sections and the referenced appendices.

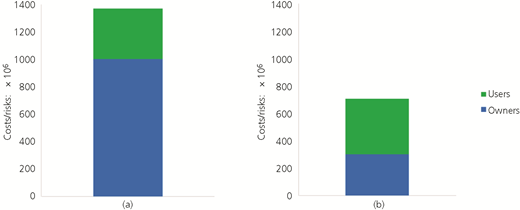

Figure 2

Total costs/risks per stakeholder: (a) strategy set 1; (b) strategy set 2

Figure 2

Total costs/risks per stakeholder: (a) strategy set 1; (b) strategy set 2

Close modal

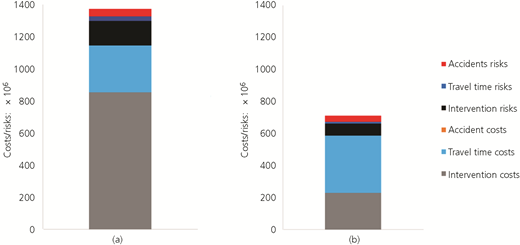

Figure 3

Total costs/risks per cost/risk type: (a) strategy set 1; (b) strategy set 2

Figure 3

Total costs/risks per cost/risk type: (a) strategy set 1; (b) strategy set 2

Close modal

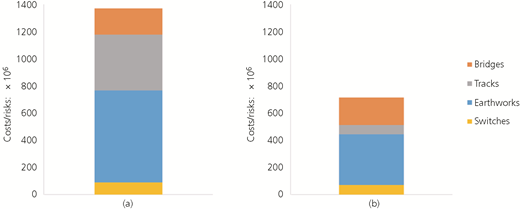

Figure 4

Total costs/risks per object type: (a) strategy set 1; (b) strategy set 2

Figure 4

Total costs/risks per object type: (a) strategy set 1; (b) strategy set 2

Close modal

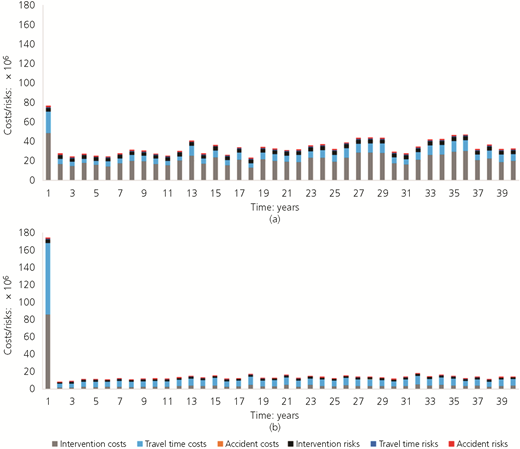

Figure 5

Total costs/risks per cost/risk type per year: (a) strategy set 1; (b) strategy set 2

Figure 5

Total costs/risks per cost/risk type per year: (a) strategy set 1; (b) strategy set 2

Close modal

Cost and risks

In order for managers to understand the effects of their decisions, they need to be able to make a number of comparisons. The usefulness of comparisons using all objects is summarised in Table 18. The usefulness of comparisons using objects of one type is summarised in Table 19.

Table 18

Usefulness of comparisons using all objects over the entire time period

Comparison for different strategy sets …Allows statements …Example
1… Of the total costs/risks… Of which in general is betterThe total costs/risks of strategy set 2 (€303 × 106) are lower than the total costs/risks of strategy set 1 (€1005 × 106); therefore, it is clear that one should choose the strategies with earlier preventive interventions – that is, do not neglect maintenance (Table 20)
2… Of the costs/risks per stakeholder… As to how each stakeholder is affected and enables discussions about trade-offs between stakeholdersThe owner should be willing to execute more on later but better preventive interventions, such as renewal interventions when objects are in state 4 – that is, strategy set 1 should be followed instead of strategy set 2 – to reduce the user costs/risks (€368 × 106 against €407 × 106) (Table 20)
3… Of the costs/risks per period of time… As to how each stakeholder is affected and enables discussions about trade-offs between the frequency and extent of interventions of different typesThe owner should be willing to spend more on earlier preventive interventions such as rehabilitation interventions when objects are in state 3 – that is, strategy set 2 should be followed instead of strategy set 1 – to reduce the risks for all stakeholders (€226 × 106 against €125 × 106) (Table 20)
4… Of the costs/risks per object type that causes them… As to where efforts should be focused to reduce costsThe largest sources of costs/risks are tracks (€51 × 106 if strategy set 2 is followed) and earthworks (€79 × 106 if strategy set 1 is followed and €16 × 106 if strategy set 2 is followed) (Table 21)
Table 19

Usefulness of comparisons using all objects in each year

Comparison for different strategy sets …Allows …Example
5… Of the total costs/risks… General statements of which is betterAlthough the total costs/risks of strategy set 2 are lower than the total costs/risks of strategy set 1 over the entire period, they are substantially higher in year 1 (€176 × 106 against €78 × 106). The costs/risks from years 2 to 40 are, however, reversed (<€20 × 106/year against <€60 × 106/year) (Figure 5)
6… Of the costs/risks per stakeholder… Statements as to how each stakeholder is affected and enables discussions about trade-offs between stakeholdersThe owner should be willing to pay more on preventive interventions than the lowest amount in year 1 – that is, €50 × 106 when following strategy set 1 against €82 × 106 when following strategy set 2 for interventions in year 1 (Figure 5) – so that there are reduced user risks over the entire time period (€75 × 106 against €50 × 106 (Table 20))
7… Of the costs/risks per period of time… Statements as to how each stakeholder is affected and enables discussions about trade-offs between the frequency and extent of interventions of different typesThe owner should be willing to pay more on preventive interventions than the lowest amount in year 1 – that is, €50 × 106 when following strategy set 1 against €82 × 106 when following strategy set 2 for interventions in year 1 (Figure 5) – so that costs of corrective interventions – that is, intervention risk is lower over the entire time period (€151 × 106 against €75 × 106 (Table 20)
8… Of the costs/risks per object type that causes them… Statements as to where efforts should be focused to reduced costsThe largest sources of costs/risks in year 1 are tracks (€103 × 106 and €51 × 106 if strategy sets 1 and 2 are followed) and earthworks (€79 × 106 if strategy set 1 is followed and €16 × 106 if strategy set 2 is followed) (Table 21)
Table 20

Total costs and risks

StakeholderLabelCosts/risksEstimationTotal costs/risks: € × 106
Strategy set 1Strategy set 2
OwneraInterventionCoststTCpi-i854228
RiskstTRf-i15175
Total intervention costs/risks1005303
Total owner costs/risks1005303
UsersTravel timeCoststTCpi-tt293357
RiskstTRf-tt3010
Total travel time costs/risks323367
AccidentCoststTCpi-a00
RiskstTRf-a4540
Total accident costs/risks4540
Total user costs/risks368407
a

The owner costs of intervention for all objects are €854 billion with strategy 1 and €228 million with strategy 2 over a network of c. 211 km for 40 years, which translate into average annual costs per kilometre of c. €101 127 and €27 032, respectively. This is in agreement with the average cost per annual maintenance of railway infrastructure in Europe by Jimenez-Redondo et al. (2012) (€30 000–100 000/(km year))

Table 21

Total costs/risks per object type

Object typeStrategy set 1: € × 106Strategy set 2: € × 106
CostsRisksTotalCostsRisksTotal
BridgeMetal2532835136
Concrete4<152<12
Masonry160<1161162<1162
Total19041931991200
TrackTotal309103412185168
EarthworkEmbankment178302071037111
Cutting422504722518260
Total6007967935516370
SwitchTotal484089145771
Total11472261373585125710

Proxies

When proxies for what matters are requested, they need to be displayed well. The displays for the proxies are shown for the entire time period in Figures 6–9. The usefulness of comparisons using all objects is summarised in Table 22.

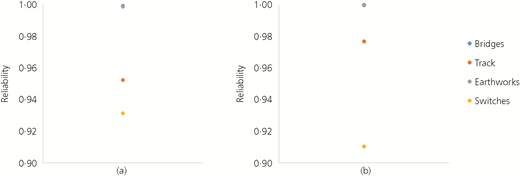

Figure 6

Average reliability of the objects in all years: (a) strategy set 1; (b) strategy set 2 (the switches are less reliable with intervention strategy 2 than with intervention strategy 1 because although there are fewer switches in state 5, there are more that are not in state 1)

Figure 6

Average reliability of the objects in all years: (a) strategy set 1; (b) strategy set 2 (the switches are less reliable with intervention strategy 2 than with intervention strategy 1 because although there are fewer switches in state 5, there are more that are not in state 1)

Close modal

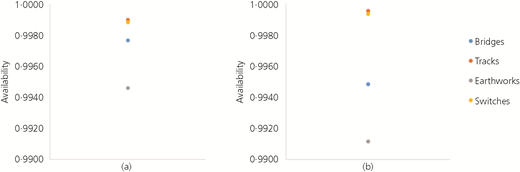

Figure 7

Average availability of the objects in all years: (a) strategy set 1; (b) strategy set 2 (there is lower availability due to bridges and earthworks when following intervention strategy 2 than when following intervention strategy 1 because there are more preventive interventions executed that take considerable amounts of time)

Figure 7

Average availability of the objects in all years: (a) strategy set 1; (b) strategy set 2 (there is lower availability due to bridges and earthworks when following intervention strategy 2 than when following intervention strategy 1 because there are more preventive interventions executed that take considerable amounts of time)

Close modal

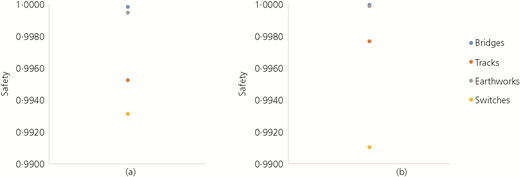

Figure 8

Average safety related to all objects in all years: (a) strategy set 1; (b) strategy set 2 (safety due to the switches decrease when intervention strategy 2 is followed compared to when intervention strategy 1 is followed because although there are fewer switches in state 5, there are more that are not in state 1)

Figure 8

Average safety related to all objects in all years: (a) strategy set 1; (b) strategy set 2 (safety due to the switches decrease when intervention strategy 2 is followed compared to when intervention strategy 1 is followed because although there are fewer switches in state 5, there are more that are not in state 1)

Close modal

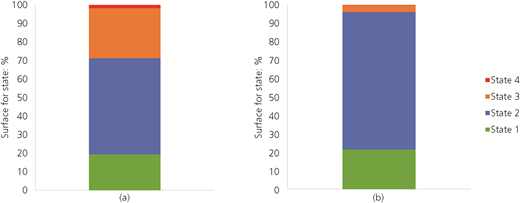

Figure 9

Average state of all objects over time period: (a) strategy set 1; (b) strategy set 2

Figure 9

Average state of all objects over time period: (a) strategy set 1; (b) strategy set 2

Close modal
Table 22

An overview of the proxies

ProxyAllows statements related to theExample
ReliabilityProbability of not providing the expected level of serviceThe illustration of the average reliability of the bridges, tracks, earthworks and switches (0·995, 0·9525, 0·9987 and 0·9314 with strategy 1 and 0·999, 0·9768, 0·9997 and 0·9103 with strategy 2) gives an indication of how likely it is that a failure might happen. Figure 6 gives an indication that if strategy set 2 is followed, the railway network will be more reliable than if strategy set 1 is followed; however, it can be seen that this is not the case for objects of all types. There is, however, no information as to how much one should spend to remedy this or who is predominantly affected by this
AvailabilityAmount of time that railway objects are likely to not provide the expected level of serviceThe illustration of the average availability of the bridges, tracks, earthworks and switches (0·9997, 0·9990, 0·9946 and 0·9988 with strategy 1 and 0·9948, 0·9996, 0·9997 and 0·9994 with strategy 2) gives an indication of how long objects will be working as intended. It can be seen (Figure 7) that if strategy set 2 is followed, the railway objects will be providing the expected level of service for more time than if strategy set 1 is followed. There is, however, no information as to how much one should spend to remedy this or who is predominantly affected by this
SafetyProbability of users being injured or losing their livesThe illustration of the average probability of being injured or killed due to an accident on a bridge, track, earthwork and switch (0·9998, 0·9952, 0·9995 and 0·9931 with strategy 1 and 1·0000, 0·9977, 0·9999 and 0·9910 with strategy 2) enables one to see (Figure 8) that following strategy set 1 will result in far fewer injuries or fatalities than following strategy set 2. This allows discussion as to how much one should spend to prevent accidents. It does not, however, enable the full picture
StateThe improvement or deterioration of the objectsThe illustration of state gives an overall approximate view of whether or not the infrastructure is getting worse and the probability that it will fail (Figure 9). It also gives an idea of the amount of money one will need to spend in the future. It is, however, meaningful only if one compares it to an optimal trajectory of the state over time

The results show that there is a difference between showing the costs related to providing an adequate level of service and not providing an adequate level of service to all stakeholders and using proxies. If the costs are used alone, one can see how each of the stakeholders is likely to be affected over the period of time being investigated. If the proxies are used alone, one can zero in on a few items that may be of particular interest to someone in an infrastructure management organisation, but it is difficult to come to a defendable decision as to which interventions should be executed on the infrastructure network. Basically, using costs enables engineers and managers to speak with each other. They show how the technical issues contained in the intervention strategies translate into the ability of the manager to ensure that his infrastructure provides an adequate level of service. Of course, there are likely many situations in which the use of proxies to emphasise what is happening in parts of the system in addition to costs will be useful, particularly if engineers or managers are used to using them.

The proposed approach may be described as a multicriteria decision analysis approach, in that it takes into consideration all criteria that are important in a system when estimating and communicating maintenance needs. A significant difference of this approach from many other multicriteria decision analysis approaches, however, is that the use of explicit weights is avoided – that is, there is no weight put on an accident and no weight put on the cost of intervention. Instead, it is proposed to place a value on how stakeholders are affected per unit time – that is, the probability of having an accident multiplied by the costs of the accident, which includes, for example, having stakeholders assign a value to an injured person and a lost life. Along these lines it is noted that the proposed approach helps to ensure that all stakeholders and how they are affected is taking into consideration and that the valuations of the impacts on stakeholders is given in directly comparable units. This is important in most situations, but particularly important in potentially controversial situations – for example, when a manager and an engineer work for different entities.

Despite all of the advantages of the proposed approach, there are numerous challenges when implementing it. These are listed as follows:.

  • It is more time intensive than basing arguments on technical aspects, as it requires first being aware of the technical aspects and then converting them to service.

  • It is not always easy to identify all of the aspects of service that one would like to value and put values on the units of them in meaningful ways. For example, how does one value the aesthetics of a bridge in a railway network when it is like new and when it is in a deteriorated state?

  • It is not easy to take into consideration widely different valuations of one unit of service between stakeholders and to estimate how these values change over time as a function of changing state of infrastructure. For example, a reduction of noise for 1 h may be worth a large amount to one stakeholder but may not be worth anything to another and the estimate of the difference in accident risk when a train is going over track in state 2 and state 3 might be challenging.

As shown in this paper, engineers and managers, with the use of the proposed approach, can, with a little effort, speak to each other. The key to this successful communication is to focus on providing the required level of service and to show clearly how technical issues can affect the provided level of service. Once arguments are made from the service point of view, then, and only then, does it make sense to investigate clearly defined proxies, such as risk, reliability, availability and safety. As this is true regardless of the infrastructure analysed or the methodology or techniques used, the proposed approach is suitable for use with many if not all of the methodologies used today, together with many, if not all, of the different asset management work prioritisation and appraisal tools used in the industry. The proposed approach, although intuitive, is one that has not yet been proposed in literature in the field of infrastructure asset management.

With the rigorous application of this approach, engineers are going to increase their ability to convince managers that they should spend more on maintenance when it is justified, and managers are going to increase their ability to explain to engineers why they are not spending on maintenance when it is not justified. To explore exactly the extent of these improvements, however, more research is required. Three example research topics are as follows

  • comparison of the use of building an argument for maintenance spending on an infrastructure networks using this approach against using others – for example, approaches based only on technical aspects, only on partial service indicators or on partial assessments of service

  • investigation of the ability of stakeholders to determine a unified definition of the service provided by infrastructure for specific types of infrastructure, their ability to place values on them and their ability to accept that interventions were not necessarily being executed when they thought they should, of which the latter may lead to stakeholders insisting on the ability to enter constraints in the optimisation models or insisting that specific interventions were to be executed regardless of the optimisation

  • investigation of the benefits of using this approach to develop the next generation of documents aimed at reporting on infrastructure to managers, politicians and the public (e.g. Asce, 2017; SBB-Infrastruktur, 2016); considerable effort goes into developing these documents currently, but the results are not normally informative enough to help decision makers objectively determine required maintenance funding levels.

This work has received funding from the European’s Union Horizon 2020 research and innovation programme under grand agreement number 636285 (Destination Rail project).

Adey
BT
2017
A process to enable the automation of road asset management
2nd International Symposium on Infrastructure Asset Management-SIAM 2017
ETH Zurich
Zurich, Switzerland
2
Adey
BT
,
Hajdin
R
2011
Methodology for determination of financial needs of gradually deteriorating bridges with only structure level data
Structure and Infrastructure Engineering
7
7–8
645
 -
660
Adey
BT
,
Hajdin
R
,
Brühwiler
E
2004
Effect of common cause failures on indirect costs
Journal of Bridge Engineering
9
2
200
 -
208
Adey
BT
,
Lethanh
N
,
Lepert
P
2012
An impact hierarchy for the evaluation of intervention strategies for public roads
Proceedings of the European Pavement and Asset Management Conference (EPAM)
Malmö, Sweden
12p-tabl
Asce (American Society of Civil Engineers)
2017
Infrastructure Report Card
Asce
Reston, VA, USA
See http://www.infrastructurereportcard.org (accessed 14/11/2018)
Budai-Balke
G
2009
Operations Research Models for Scheduling Railway Infrastructure Maintenance
Erasmus University Rotterdam
Rotterdam, the Netherlands
See http://repub.eur.nl/pub/16008 (accessed 14/11/2018)
Calle-Cordon
A
,
Jiménez-Redondo
N
,
Morales-Gámiz
FJ
, et al
2017
Integration of RAMS in LCC analysis for linear transport infrastructures: a case study for railways
IOP Conference Series: Materials Science and Engineering
236
1
12106
Carretero
J
,
Péreza
JM
,
Garcıa-Carballeira
F
, et al
2003
Applying (RCM) in large scale systems: a case study with railway networks
Reliability Engineering & System Safety
82
3
257
 -
273
Caterino
N
,
Iervolino
I
,
Manfredi
G
,
Cosenza
E
2006
Multi-criteria decision making for seismic retrofitting of an underdesigned RC structure
Proceedings of the First European Conference on Earthquake Engineering and Seismology
Geneva, Switzerland
3
 -
8
Celebi
D
,
Bayraktar
D
,
Ozturkcan
S
2008
Multi criteria classification for spare parts inventory
Proceedings of the 38th Computer and Industrial Engineering Conference
Beijing, China
1780
 -
1787
Chang
SE
,
Nojima
N
2001
Measuring post-disaster transportation system performance: the 1995 Kobe earthquake in comparative perspective
Transportation Research Part A: Policy and Practice
35
6
475
 -
494
Cheng
YH
,
Tsao
HL
2010
Rolling stock maintenance strategy selection, spares parts’ estimation, and replacements’ interval calculation
International Journal of Production Economics
128
1
404
 -
412
Dawotola
AW
,
Van Gelder
P
,
Vrijling
JK
2009
Risk assessment of petroleum pipelines using a combined analytical hierarchy process-fault tree analysis (AHP-FTA)
Proceedings of the 7th International Probabilistic Workshop
Delft, the Netherlands
De Neufville
R
,
Scholtes
S
2011
Flexibility in Engineering Design
MIT Press
Cambridge, MA, USA
De Neufville
R
,
Scholtes
S
,
Wang
T
2006
Real options by spreadsheet: parking garage case example
Journal of Infrastructure Systems
12
2
107
 -
111
De Neufville
R
,
Lee
YS
,
Scholtes
S
2008
Using flexibility to improve value-for-money in hospital infrastructure investments
Proceedings of the 2008 First International Conference on Infrastructure Systems and Services: Building Networks for a Brighter Future (INFRA)
Rotterdam, the Netherlands
1
 -
6
Ebrahimnejad
S
,
Mousavi
SM
,
Tavakkoli-Moghaddam
R
,
Hashemi
H
,
Vahdani
B
2012
A novel two-phase group decision making approach for construction project selection in a fuzzy environment
Applied Mathematical Modelling
36
9
4197
 -
4217
Ellingham
I
,
Fawcett
W
2007
New Generation Whole-life Costing: Property and Construction Decision-making under Uncertainty
Routledge
London, UK
Esders
M
,
Della Morte
N
,
Adey
BT
2015
A methodology to ensure the consideration of flexibility and robustness in the selection of facility renewal projects
International Journal of Architecture, Engineering and Construction
4
3
126
 -
139
Esders
M
,
Adey
BT
,
Lethanh
N
2016
Using real option methods as a tool to determine optimal building work programs
Structure and Infrastructure Engineering
12
11
1395
 -
1410
Fecarotti
C
,
Andrews
J
,
Remenyte-Prescott
R
2015
Modelling railway service reliability in the event of failures
Safety and Reliability of Complex Engineered Systems: ESREL 2015
Podofillini
L
,
Sudret
B
,
Stojadinovic
B
,
Zio
E
,
Kröger
W
CRC Press
Boca Raton, FL, USA
1540
 -
1545
Frangopol
DM
,
Liu
M
2007
Maintenance and management of civil infrastructure based on condition, safety, optimization, and life-cycle cost
Structure and Infrastructure Engineering
3
1
29
 -
41
Guhnemann
A
,
Laird
JJ
,
Pearman
AD
2012
Combining cost–benefit and multi-criteria analysis to prioritise a national road infrastructure programme
Transport Policy
23
15
 -
24
Jaedicke
C
,
Van Den Eeckhaut
M
,
Nadim
F
, et al
2013
Identification of landslide hazard and risk ‘hotspots’ in Europe
Bulletin of Engineering Geology and the Environment
73
2
325
 -
339
Jafarian
E
,
Rezvani
MA
2012
Application of fuzzy fault tree analysis for evaluation of railway safety risks: an evaluation of root causes for passenger train derailment
Proceedings of the Institution of Mechanical Engineers, Part F: Journal of Rail and Rapid Transit
226
1
14
 -
25
Jimenez-Redondo
N
,
Bosso
N
,
Zeni
L
, et al
2012
Automated and cost effective maintenance for railway (ACEM-Rail)
Procedia – Social and Behavioural Sciences
48
1058
 -
1067
Kurauchi
F
,
Uno
N
,
Sumalee
A
,
Seto
Y
2009
Network evaluation based on connectivity vulnerability
Transportation and Traffic Theory 2009: Golden Jubilee
Lam
WHK
,
Wong
SC
,
an Lo
HK
Springer
Boston, MA, USA
637
 -
649
Liu
M
,
Frangopol
DM
2004
Optimal bridge maintenance planning based on probabilistic performance prediction
Engineering Structures
26
7
991
 -
1002
Liu
XH
,
Han
M
,
Lin
XH
,
Yang
NP
2014
Quantitative safety assessment based on risk in level-crossing between railway and highway
Applied Mechanics and Materials
536
854
 -
857
Lyngby
N
,
Hokstad
P
,
Vatn
J
2008
RAMS management of railway tracks
Handbook of Performability Engineering
Misra
KB
Springer
London, UK
1123
 -
1145
Martani
C
,
Jin
Y
,
Soga
K
,
Scholtes
S
2016
Design with uncertainty: the role of future options for infrastructure integration
Computer-aided Civil and Infrastructure Engineering
31
10
733
 -
748
Martani
C
,
Cattarinussi
L
,
Adey
BT
2018
A new process for the evaluation of the net-benefit of flexible ground-floor ceiling in the face of use transition uncertainty
Journal of Building Engineering
15
156
 -
170
Papathanasiou
N
,
Martani
C
,
Adey
B
2016
Deriverable D3.2 Risk Assessemt Methodology
DESTination RAIL
Brussels, Belgium
Patra
AP
2009
Maintenance Decision Support Models for Railway Infrastructure using RAMS & LCC Analyses
Lulea University of Technology
Lulea, Sweden
Peng
F
2011
Scheduling of Track Inspection and Maintenance Activities in Railroad Networks. PhD thesis
University of Illinois at Urbana-Champaign
Champaign, IL, USA
Peng
F
,
Ouyang
Y
2014
Optimal clustering of railroad track maintenance jobs
Computer-aided Civil and Infrastructure Engineering
29
4
235
 -
247
Peterson
SK
,
Church
RL
2008
A framework for modeling rail transport vulnerability
Growth and Change
39
4
617
 -
641
SBB-Infrastruktur
2016
Netzzustandsbericht 2015
SBB-Infrastruktur
Bern, Switzerland
Stein
SM
,
Young
GK
,
Trent
RE
,
Pearson
DR
1999
Prioritizing scour vulnerable bridges using risk
Journal of Infrastructure Systems
5
3
95
 -
101
Sun
L
,
Gu
W
2011
Pavement condition assessment using fuzzy logic theory and analytic hierarchy process
Journal of Transportation Engineering
137
9
648
 -
655
Thoft-Christensen
P
2009
Life-cycle cost–benefit (LCCB) analysis of bridges from a user and social point of view
Structures & Infrastructure Engineering
5
1
49
 -
57
Zhang
L
,
Wu
X
,
Ding
L
,
Skibniewski
MJ
2013
A novel model for risk assessment of adjacent buildings in tunneling environments
Building and Environment
65
185
 -
194
Zhao
J
,
Chan
A
,
Stirling
A
,
Madelin
K
2006
Optimizing policies of railway ballast tamping and renewal
Transportation Research Record
1943
50
 -
56
Zio
E
,
Marella
M
,
Podofillini
L
2007
Importance measures-based prioritization for improving the performance of multi-state systems: application to the railway industry
Reliability Engineering & System Safety
92
10
1303
 -
1314
This is an open-access article distributed under the terms of the Creative Commons Attribution License, which permits unrestricted use, distribution, and reproduction in any medium, provided the original work is properly cited.

or Create an Account

Close Modal
Close Modal

Gift article access

As a benefit of your subscription, you can share temporary access to restricted articles.

Each link will stop working after 30 days or 10 uses. You may create up to 10 links in a 30 day period.

Please sign in to your personal account to gift article access.

Register

Gift article access

As a benefit of your subscription, you can share temporary access to restricted articles.

Each link will stop working after 30 days or 10 uses. You may create up to 10 links in a 30 day period.

Gift articles remaining: --

Gift article access

Each link will stop working after 30 days or 10 uses. You may create up to 10 links in a 30 day period.

Gift articles remaining: --

Gift article access

As a benefit of your subscription, you can share temporary access to restricted articles.

Each link will stop working after 30 days or 10 uses.

You have reached the limit of 10 links within a 30 day period.
